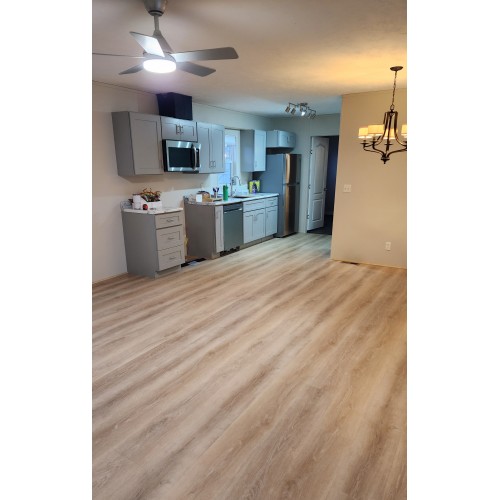

- 1125 Russel St
-
$0.00
Link to Previous pics n info March 16 ~ 27th
Link to Previous pics n info March 28 ~ April 12th
Monday - April 13th - 6 hrs (1~9pm (- 2hrs))

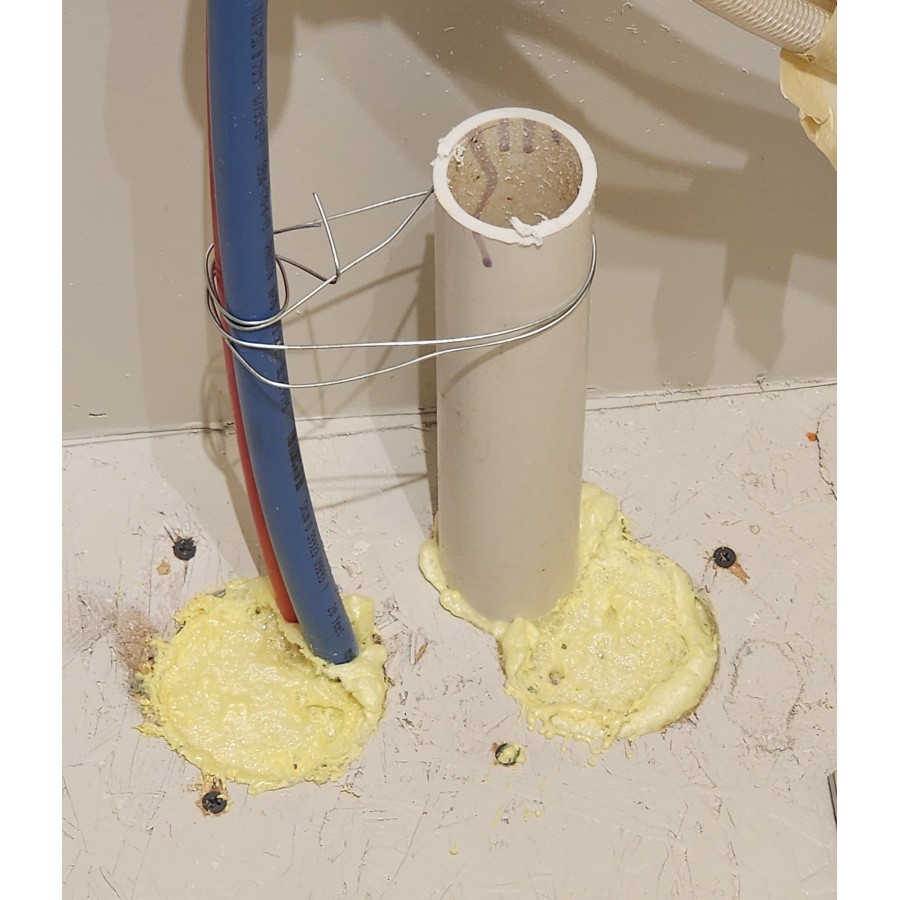

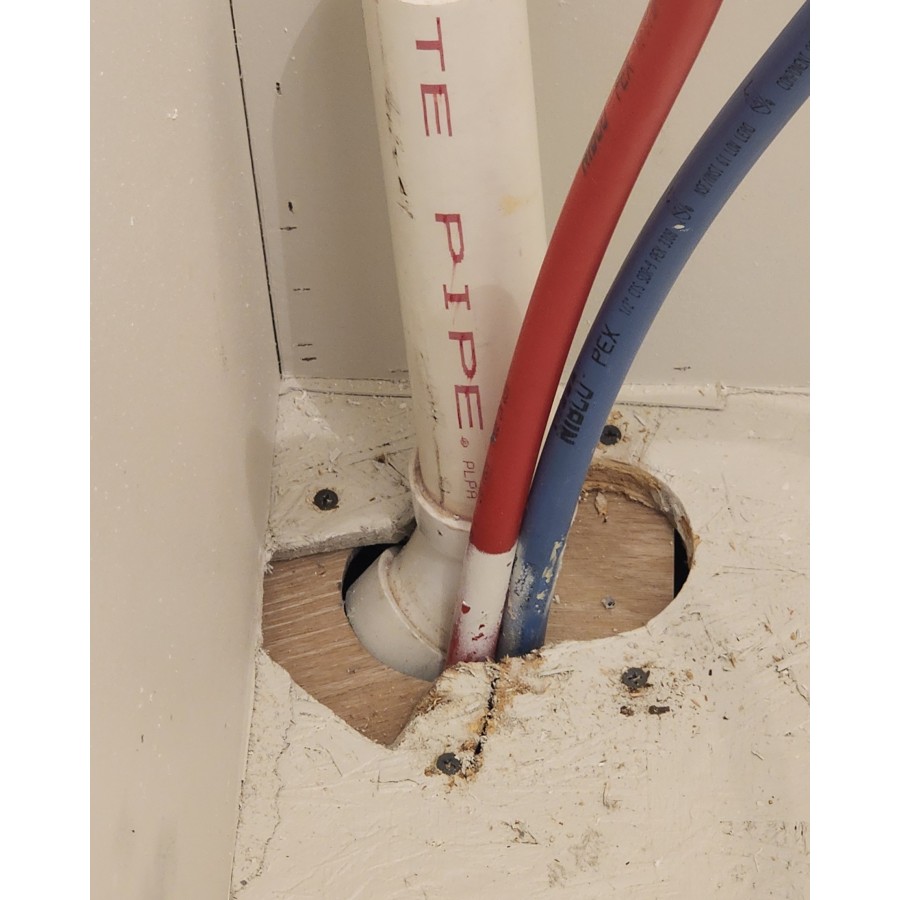

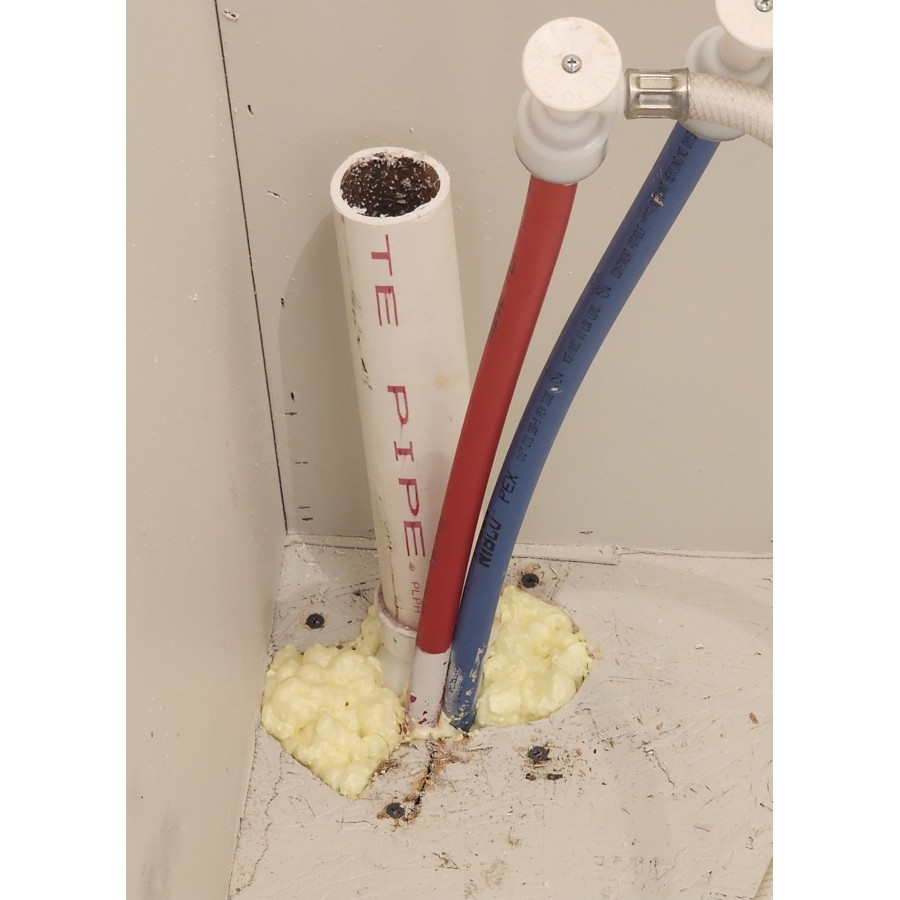

- Sealed holes around plumbing, Foam n caulk

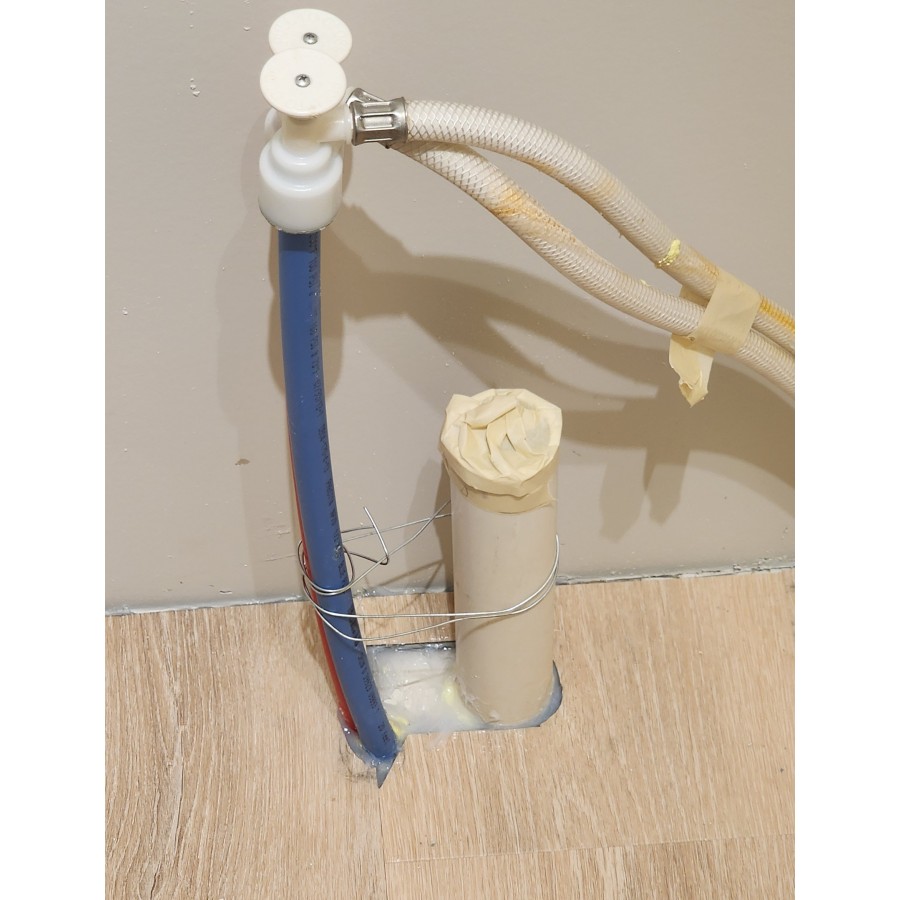

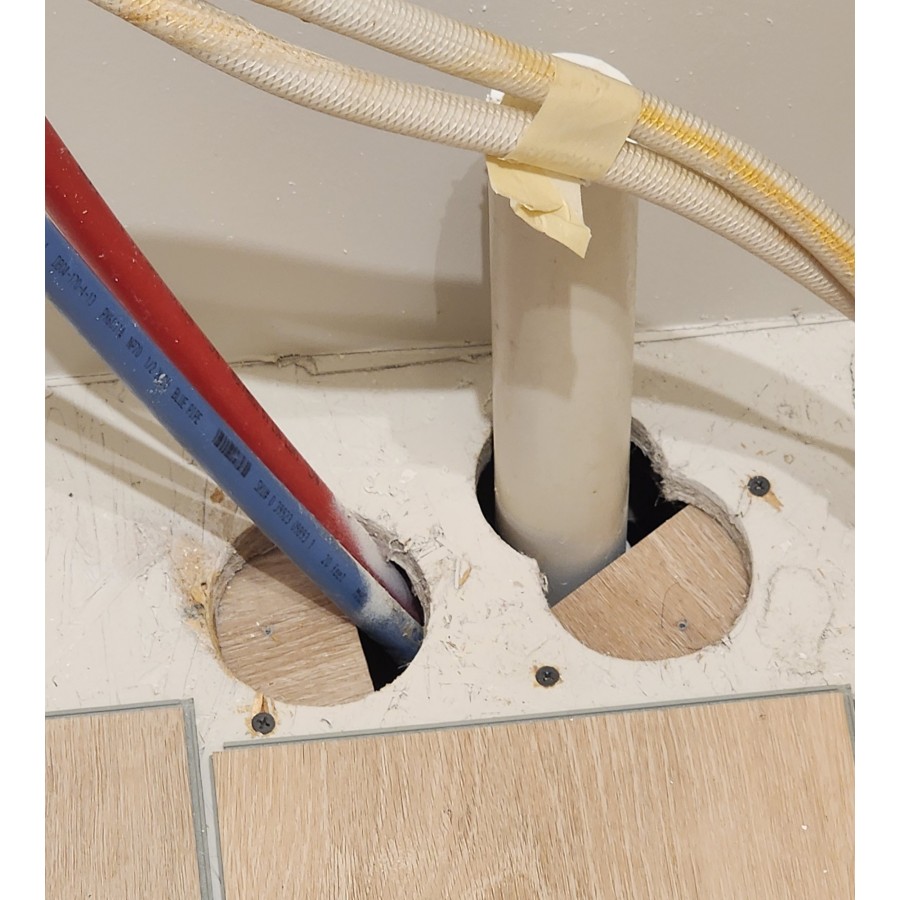

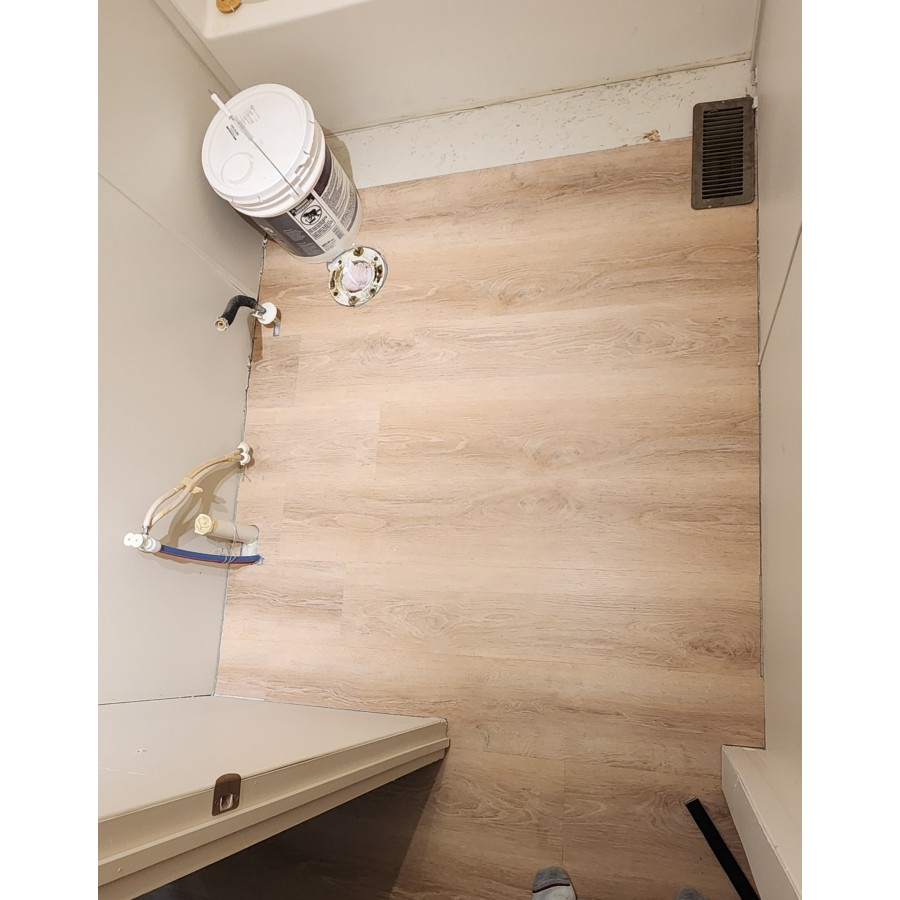

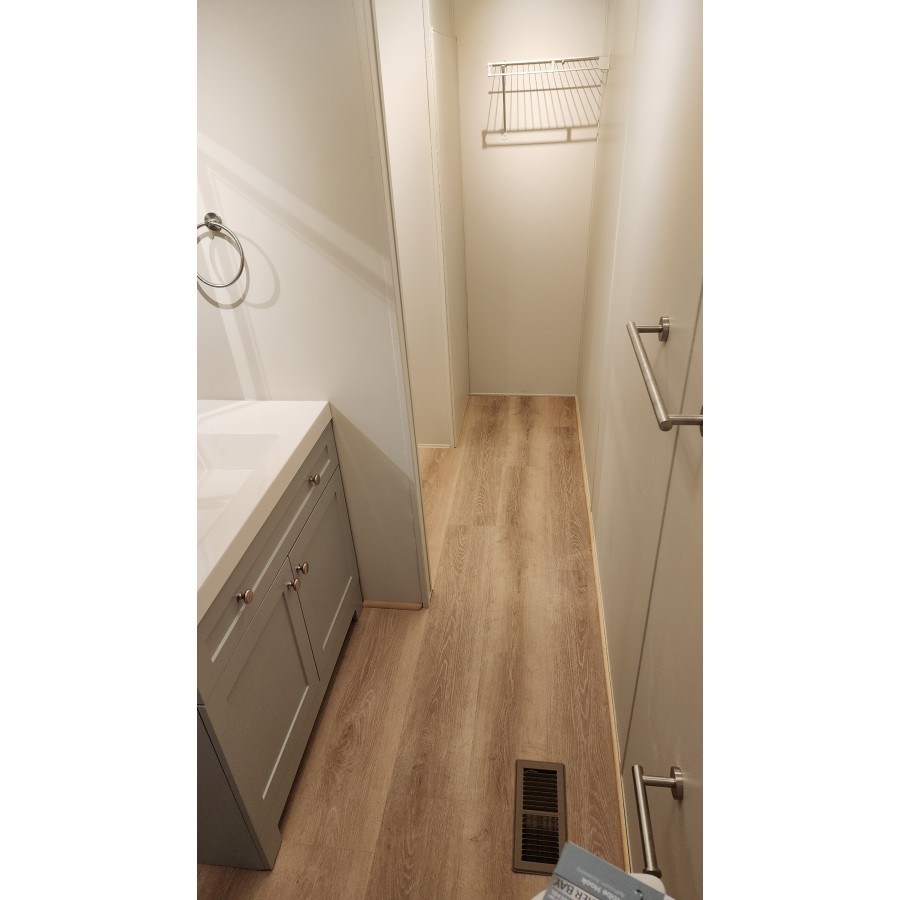

- LVP Bathroom Floor
- Kitchen sink cabinet measured out for cutting
- Need outlet extender box 3/4
Tuesday - April 14th - 5 hrs (9~5pm (- 3hrs))

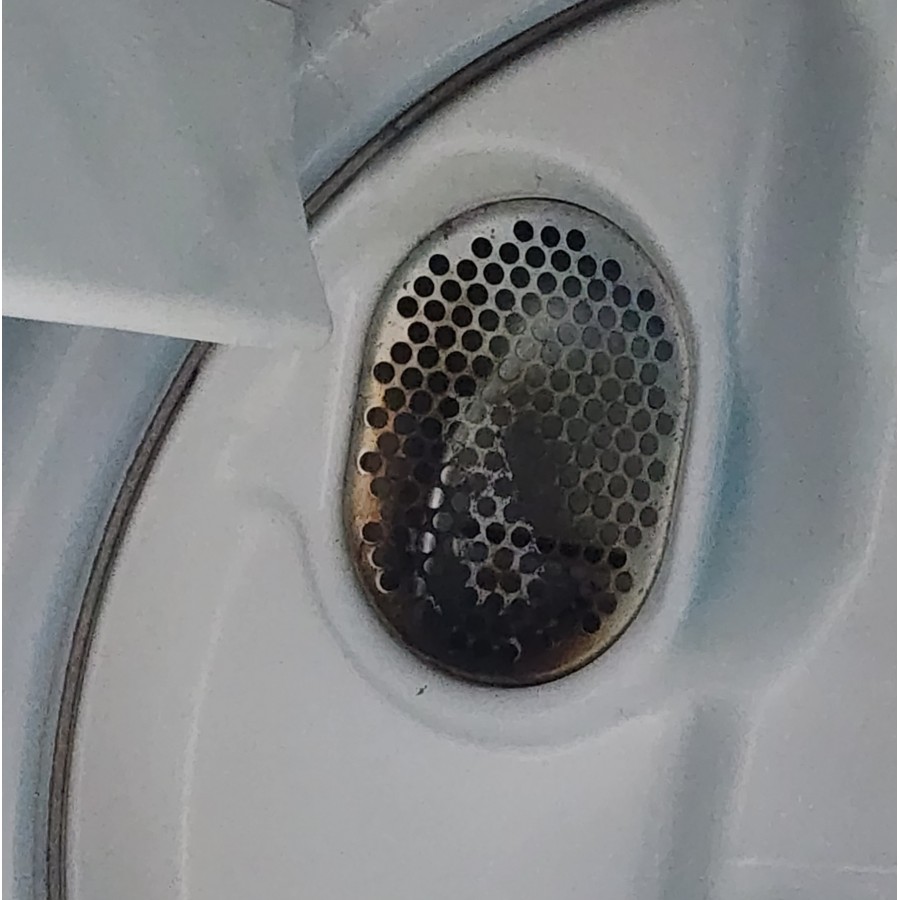

- cleaned out dryer vent
- LVP floor
Wednesday - April 15th - 6 hrs (12:30~8:30pm (- 2hrs))
- prepped bathroom vanities

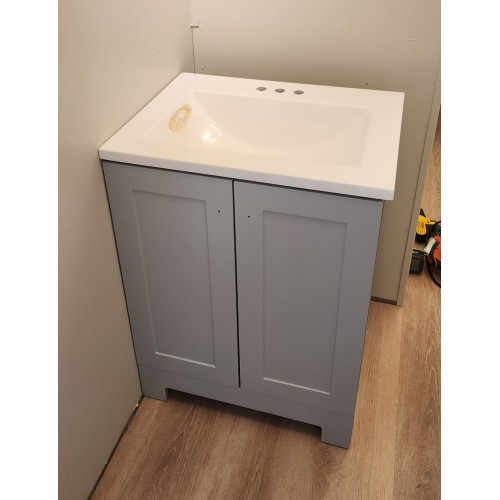

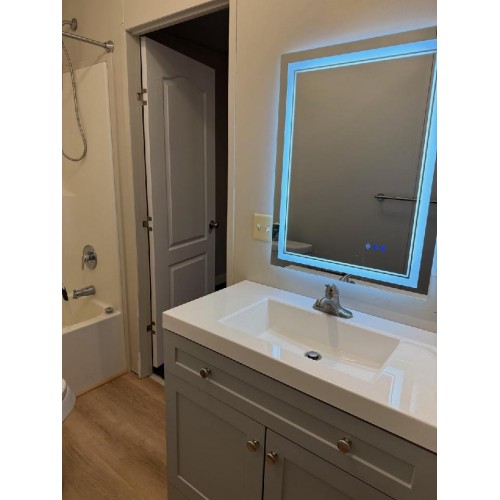

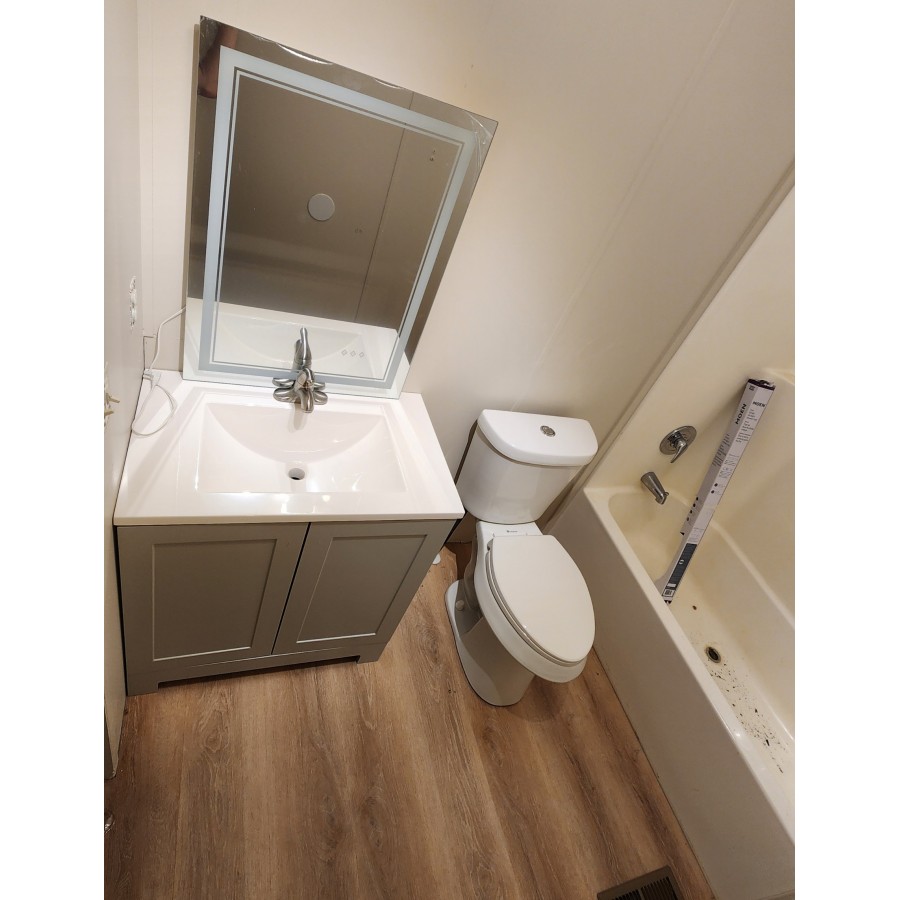

- installed main bath vanity n toilet
Thursday - April 16th - 4 hrs (10:30~4 (-1.5hrs))
- installed master bath vanity n toilet
- Finished off master bath floor
Friday - April 17th - 8 hrs (9:30~8pm (-2.5hrs))

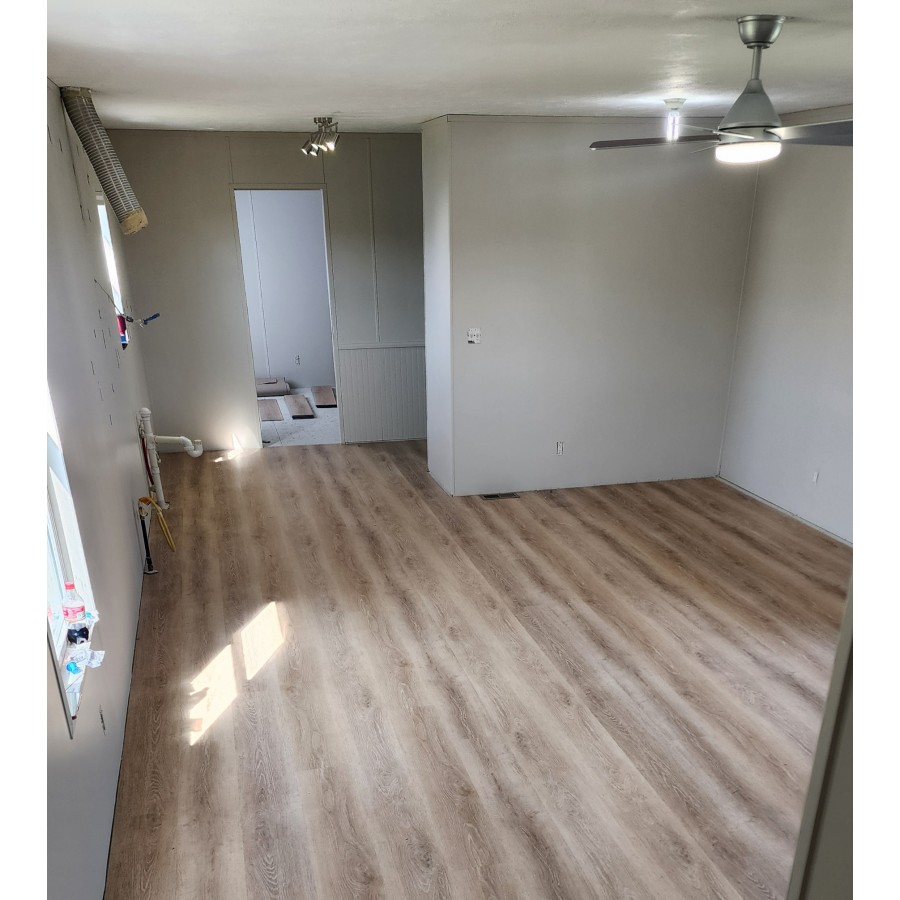

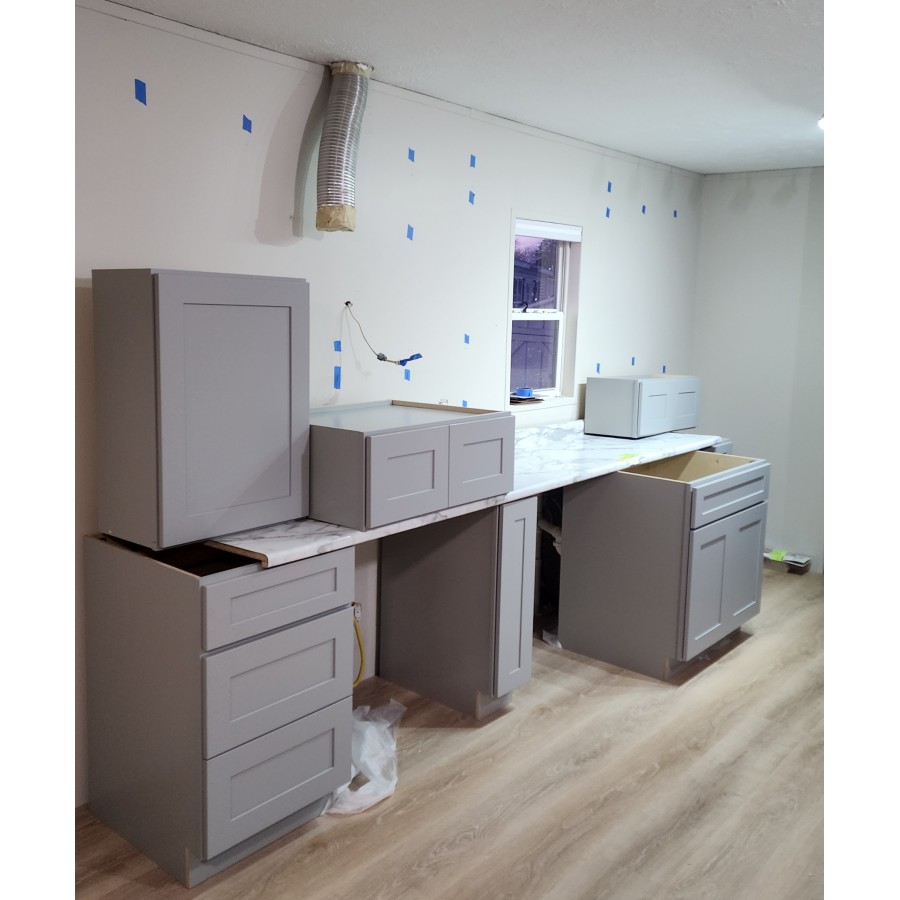

- Finished laying LVP back wall and door.
- HD for replacing vanity sink (1hr)
- sharkbite needs replacing
- vanity sink drawer too close to corner bead, need to cut drain hole more and move vanity over 1/4", find moulding to fill gap.
- toilets adjusted for optimal flush
- AC not working, (condenser wiring was cut) Wires spliced and fixed. Fuse blew on furnace contol board, ordered more 3 amp fuses on Amazon. ($5 for 20pc vs Ace $9 for 2
- cardboard removed and disposed of.
- Front room cleaned up
- no need for Extra Flooring, 4pc remaining
Saturday - April 18th - 8 hrs (9~8pm (-3hrs))
- outlet and switch plates cleaned and put on
- master vanity taken out and fixed
- laid out and started trim work
- hung up wire racking

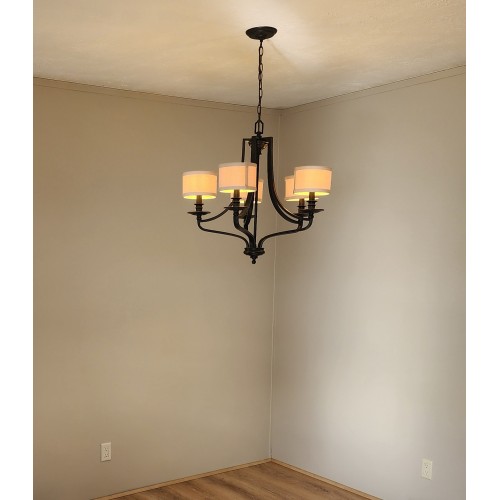

- hung chandelier
- Hung diner light
- Furnace fuse replaced and got AC working
- cleaned up work rooms
Sunday - April 19th - 7 hrs (9:30~6:30pm (-3hrs))
- more trim work
- putting Master bath Vanity back.
- trim, and caulk bathroom tubs
Monday - April 20th - 9 hours (10~8pm (-1hr))
- installed kitchen sink cabinet (2 people)
- re-measured and set base cabinets
- finishing trim
- re-installed fire alarms face plates (need batteries)
-Bathroom sinks siliconed down as well as cabinet to floor
Tuesday - April 21st - 9 hours (9~7pm (-1hr))
- Base cabinets screwed to wall
- Hung 3 cabinets.
- Finished trim in Laundry room
- appliances put in place
Wednesday - April 22nd - 10 hours (8~9pm (-3hrs))

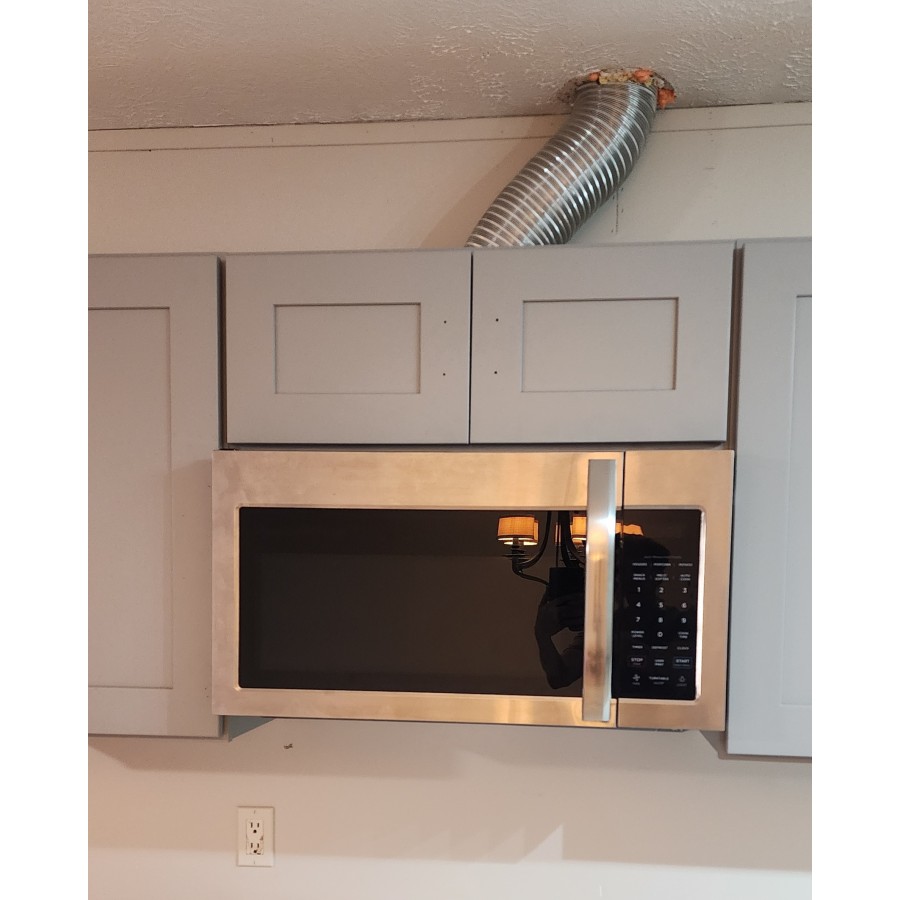

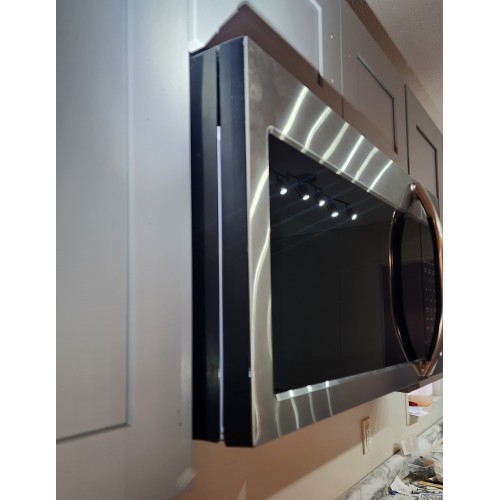

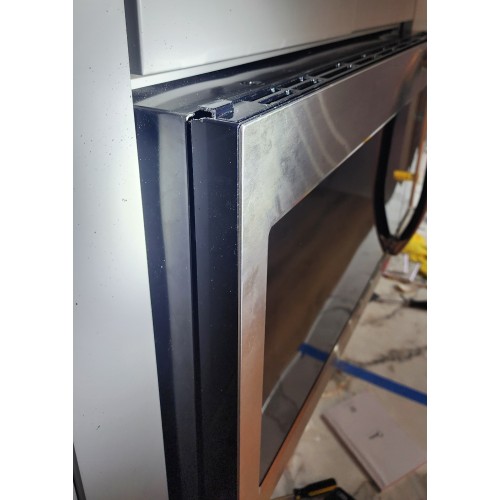

- Cut holes in cabinet above Microwave
- wired outlet for Microwave
- Microwave door catching on trim... cut end off
Thursday - April 23rd - 10 hours (8:30~9:30pm (-3hrs))

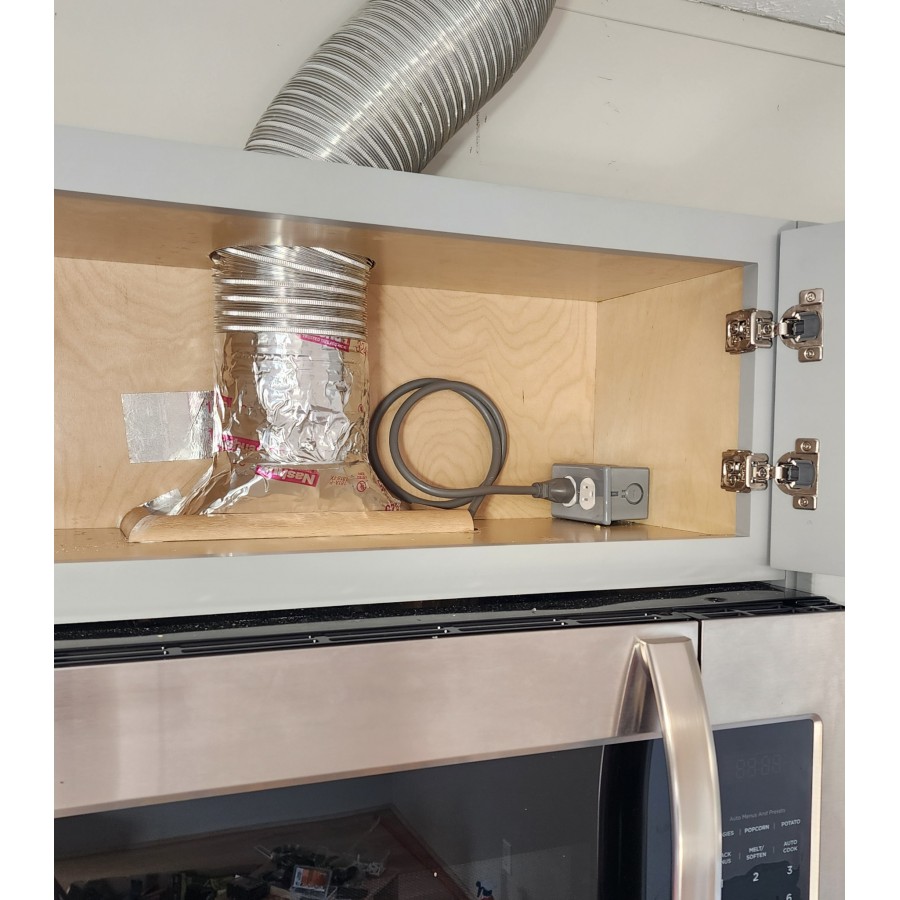

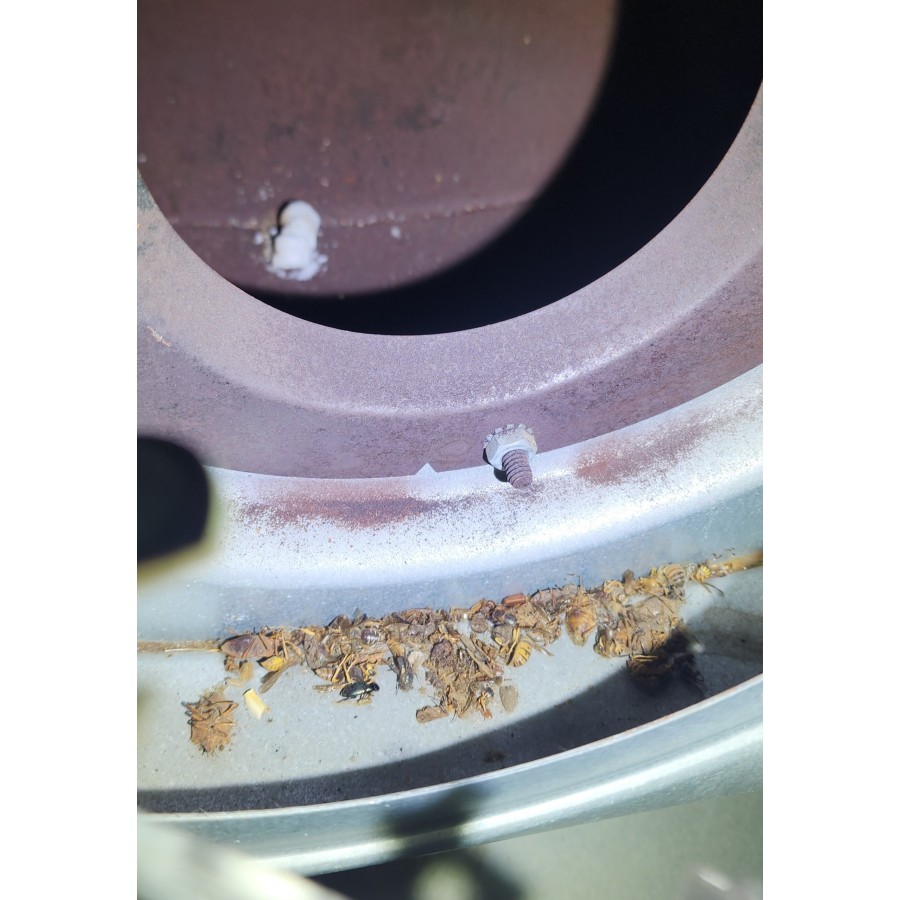

- taped air ducts underside for loss of air
- got neighbor to cut grass ($20)
Friday - April 24th - 10 hours (9~9pm (-2hrs))

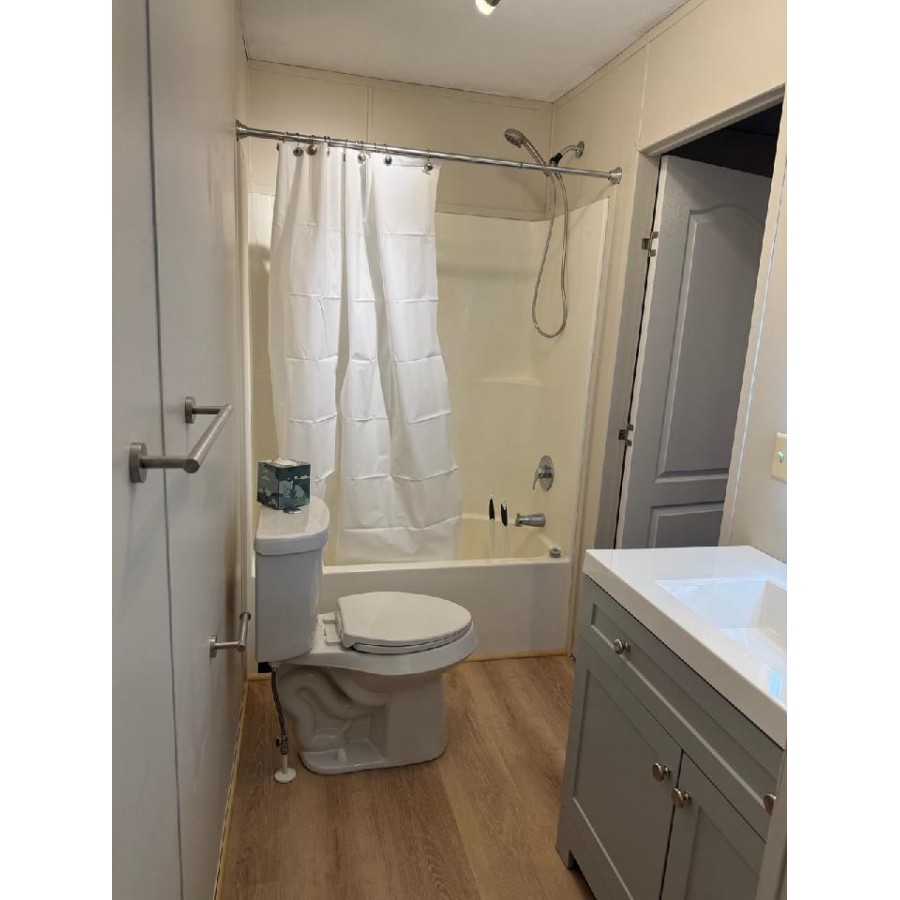

- hung towel bars and toilet roll holders in bathrooms

- cut counter tops to fit (2 people)
- Cleaned house best a man can do
- layed out carpet in back room
Saturday - April 25th - 6 hrs (9~5pm (-2hrs)
- cleaned house for Ashley
- mudded holes
- finished trim, caulk 1/2the master bath to see looks

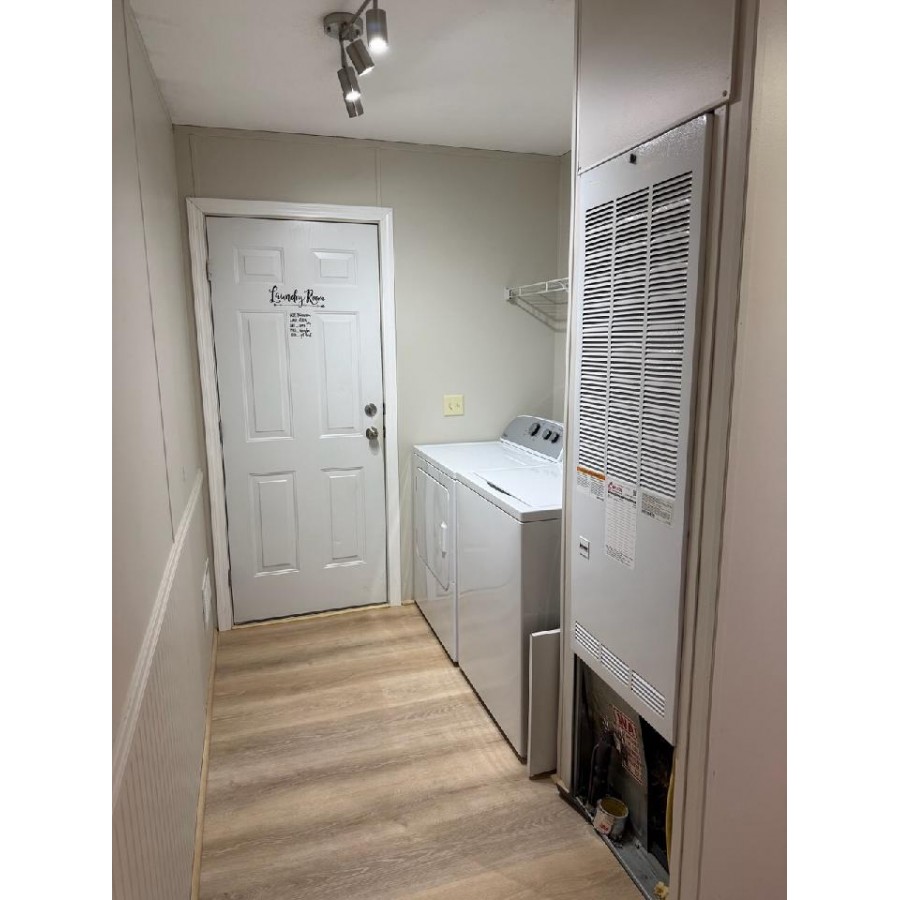

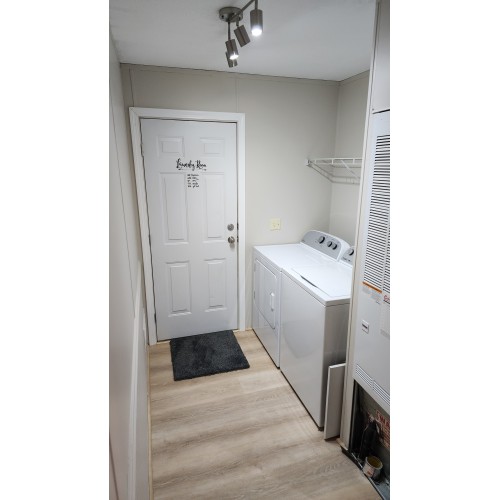

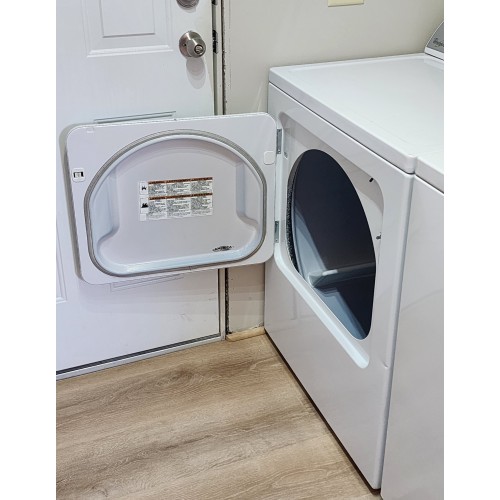

- hooked up dryer vent (PITA), switch door side to open left side
- weighted counter to offset cup and curve (it did not work BTW)
- Aahlie cleaned 1 side of doors to paint
- primed master bedroom ceiling that had bleed thru (2 coats)
Sunday - April 26th - 5 hrs (1~8 (-2hrs))
- Measured countertop sink and marked dims
- cleaned and painted doors
- Fixed gas line
- moved electrical box for microwave
- Hung front door before dark
- painted master bedroom ceiling that had bleed thru (2 coats)
- painted all the doors
Monday - April 27th - 8 hrs (10~9:30pm (-3.5hrs))
- handles put on cabinets
- sink cut out... end pieces ironed on

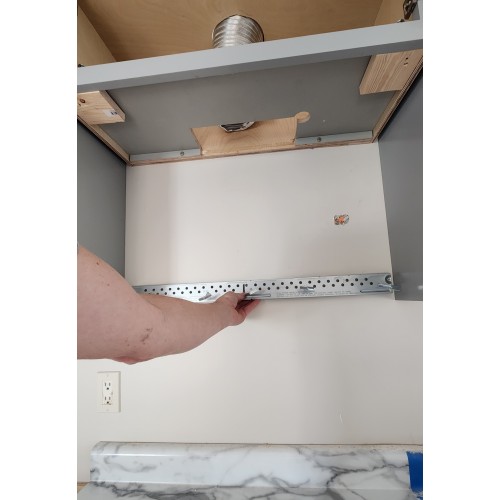

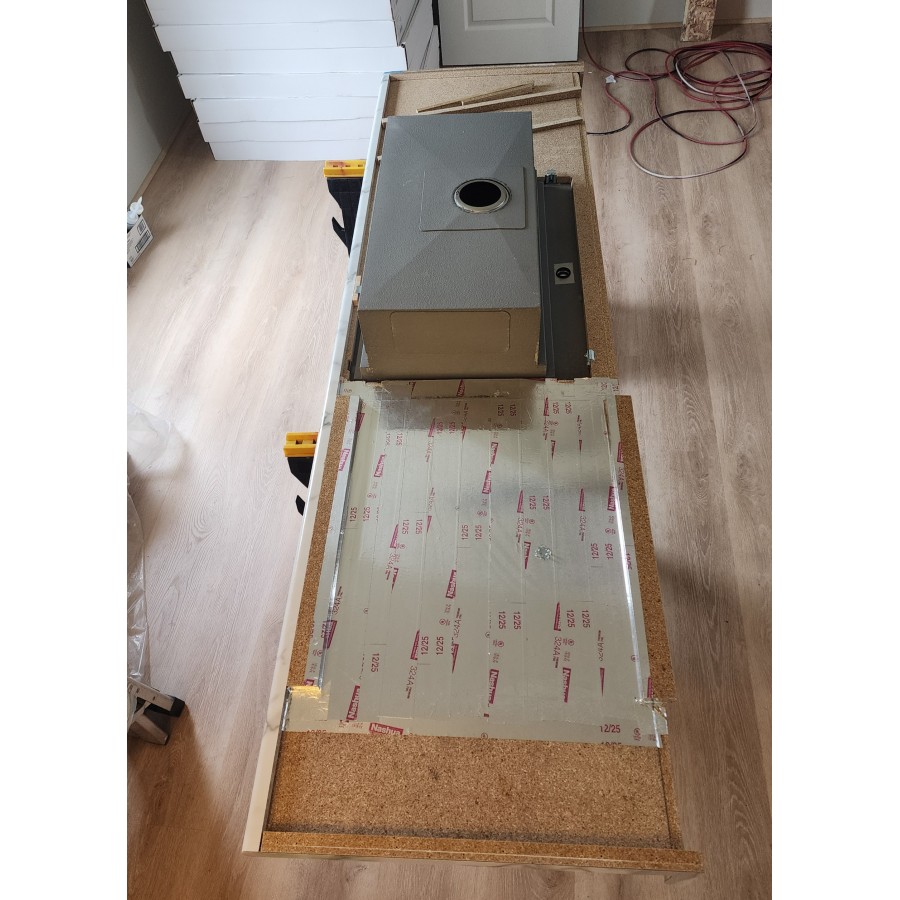

- underside of counter sealed with aluminum barrier tape for moisture proofing. (refer picture)
- bracing blocks glued and nailed on lower cabinet for countertop
- tried to use screw down brackets for sink, but they are not correct ones for thickness of Countertop, very week teflon screw (no pulling power)
- cleaned work rooms
Tuesday - April 28th - 10 hrs (9~10 (-3hrs))

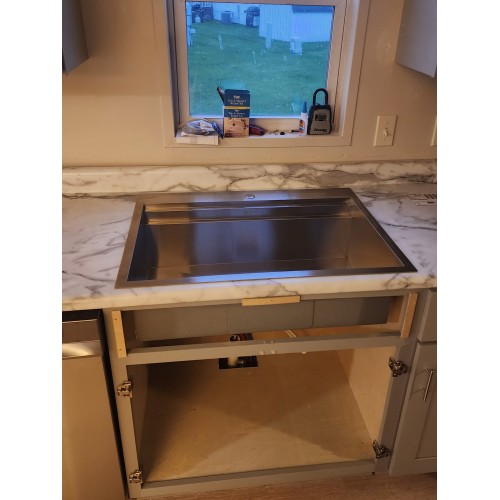

- installed sink

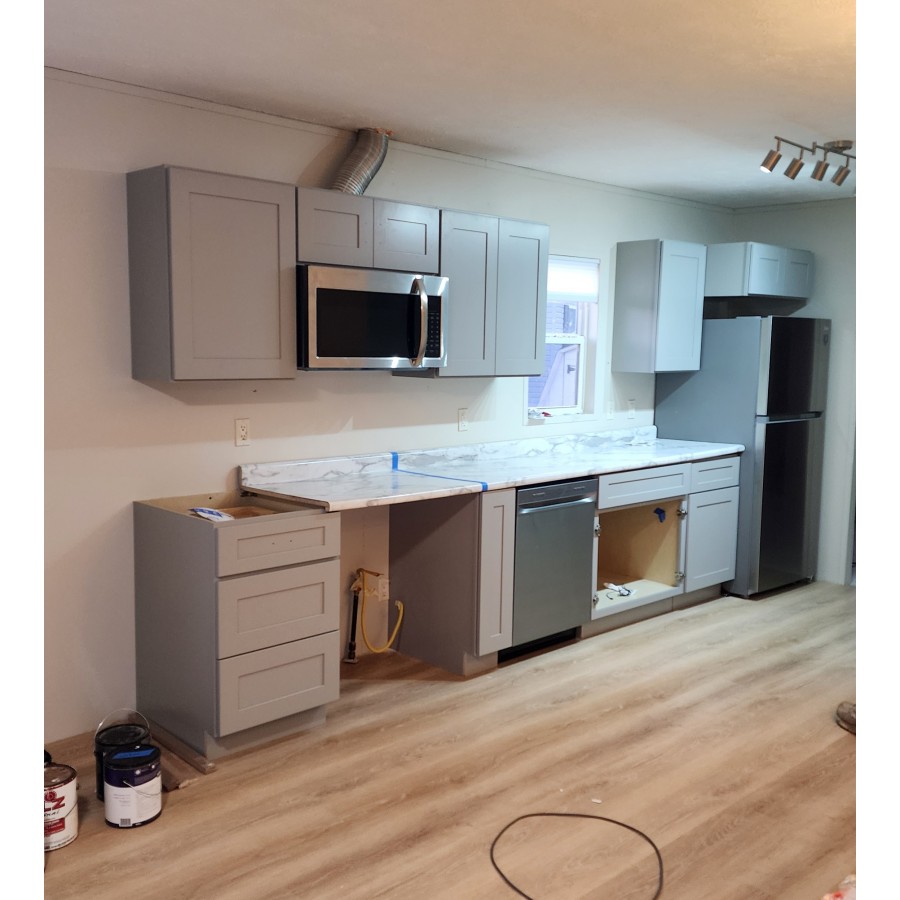

- installed dishwasher

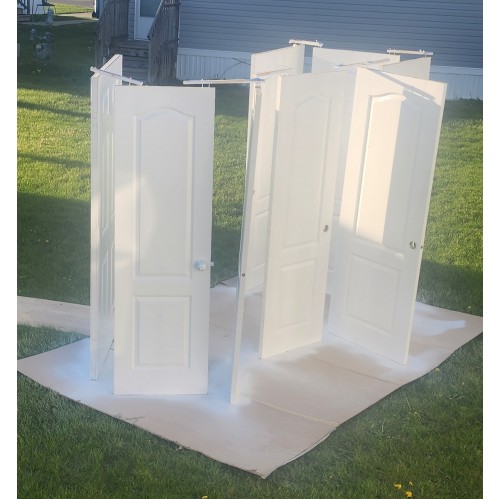

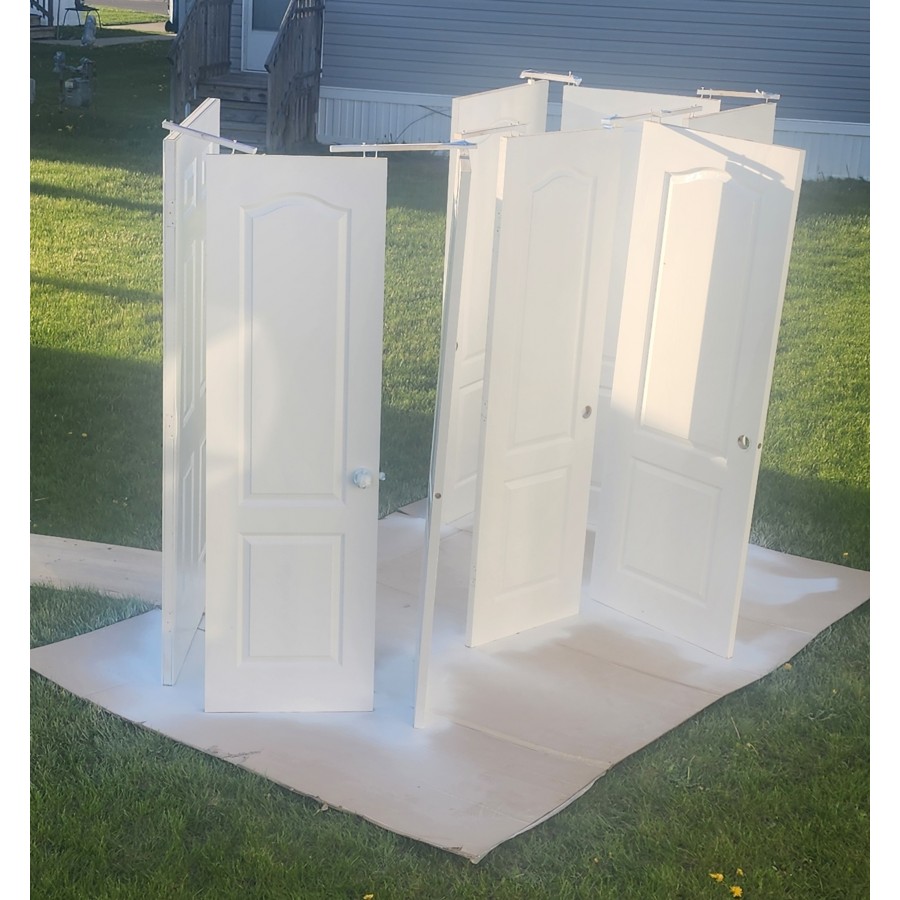

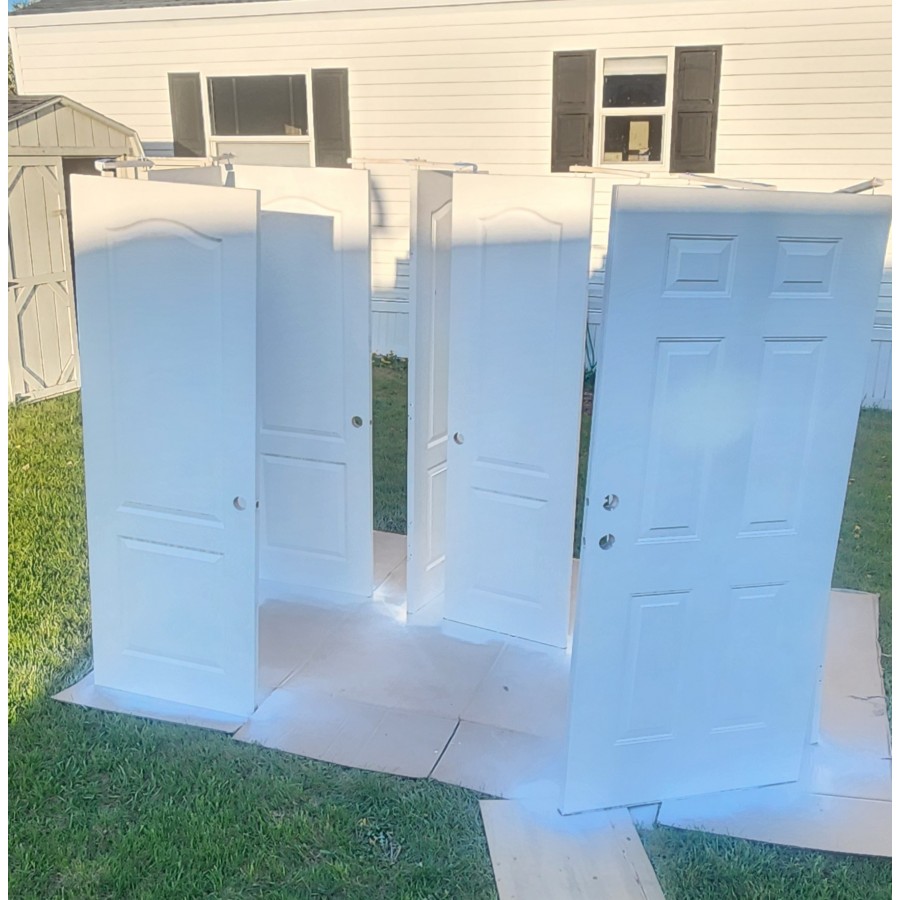

- installed some doors

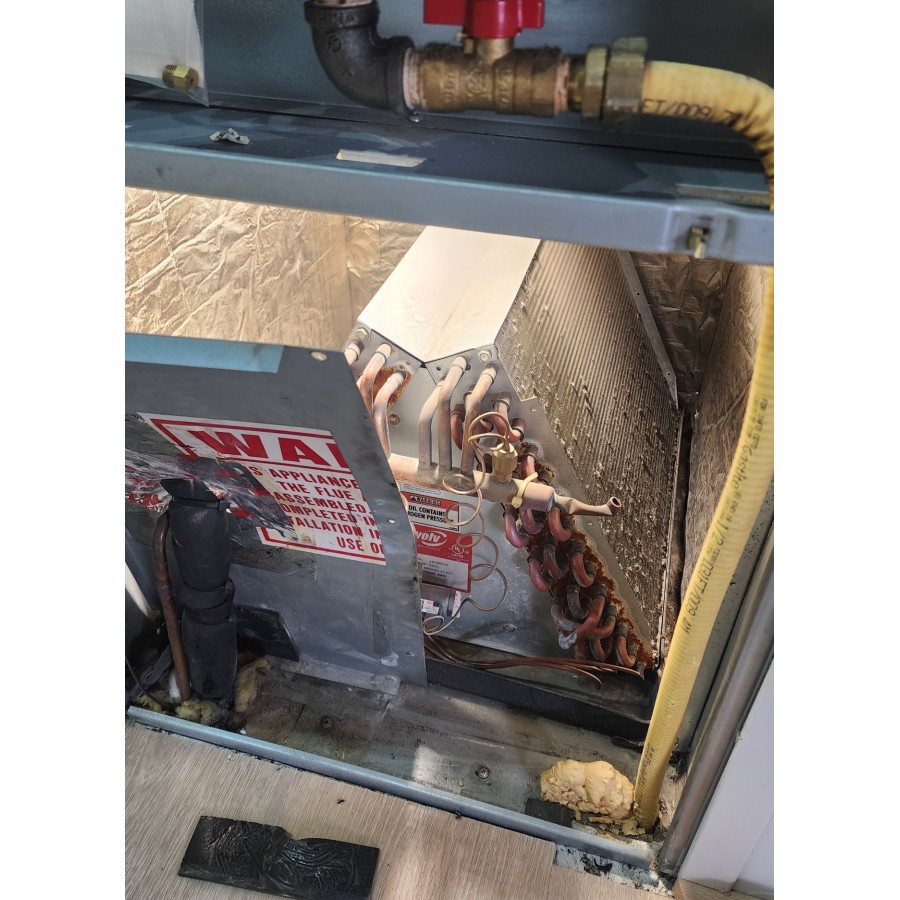

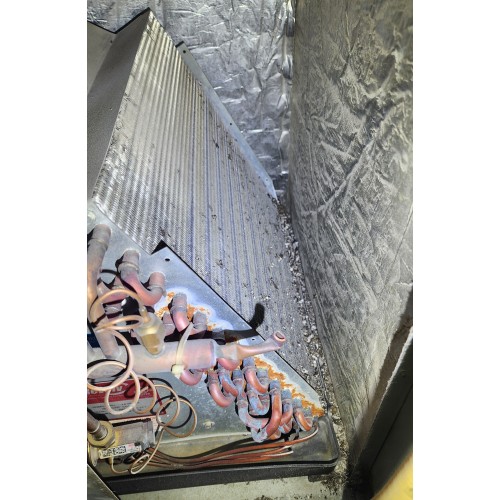

- "A coil" on furnace dirty, semi cleaned it.
- painted door trim, 3 coats
- started hanging door trim, OMG (they cut it)

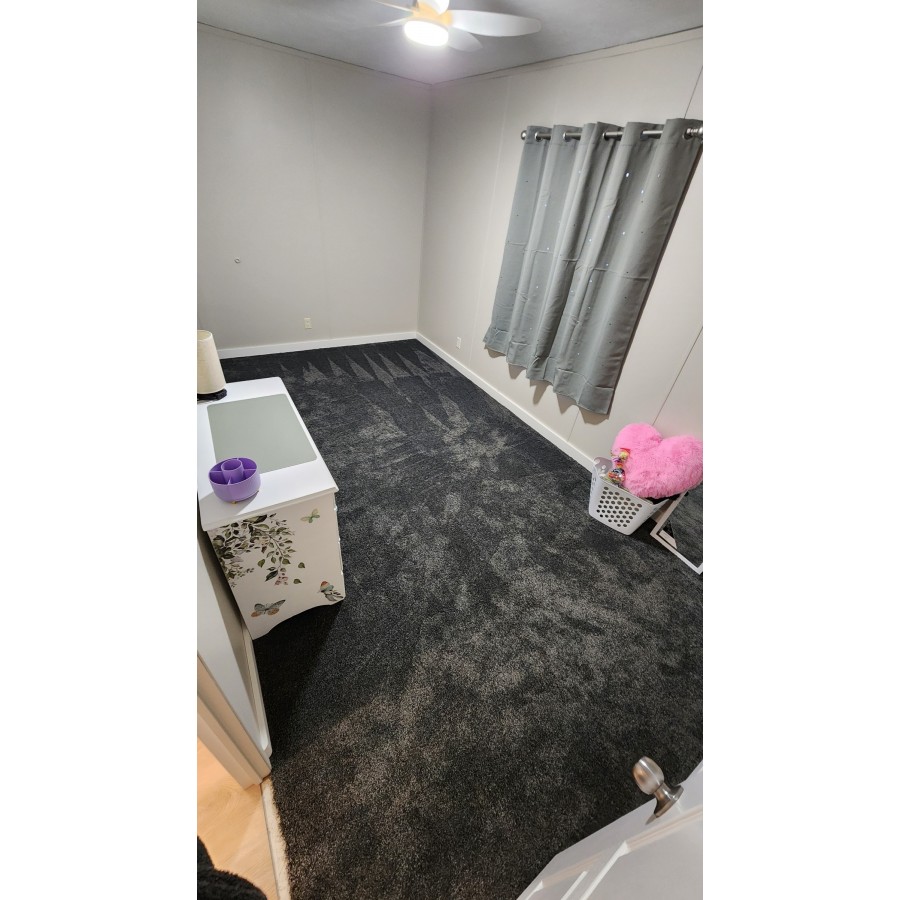

- laid carpet in master bedroom (3/4)
- weighted sink down to let silicone adhere
- cleaned back room to lay carpet tomorrow
Wednesday - April 29th -18 hrs (9~3am

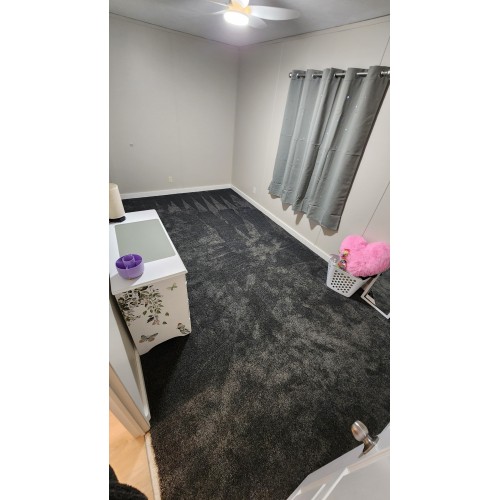

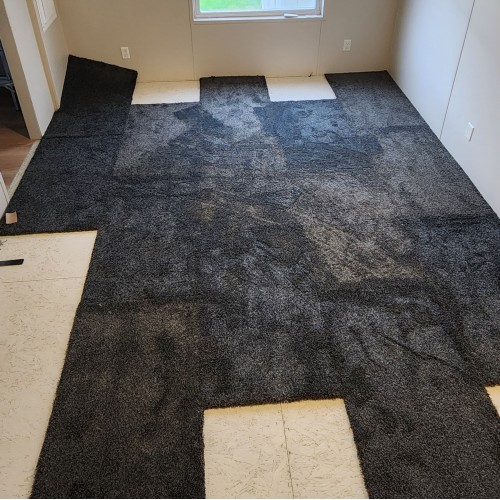

- Carpet in 2 bedrooms
- hallway light installed
- doors hardware put back on and hung
Thursday - April 28th - 10 hrs (9~8pm)
- sink drain installed

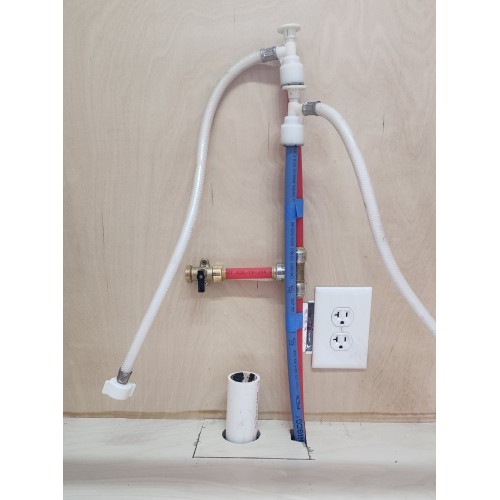

- water hooked up to sink

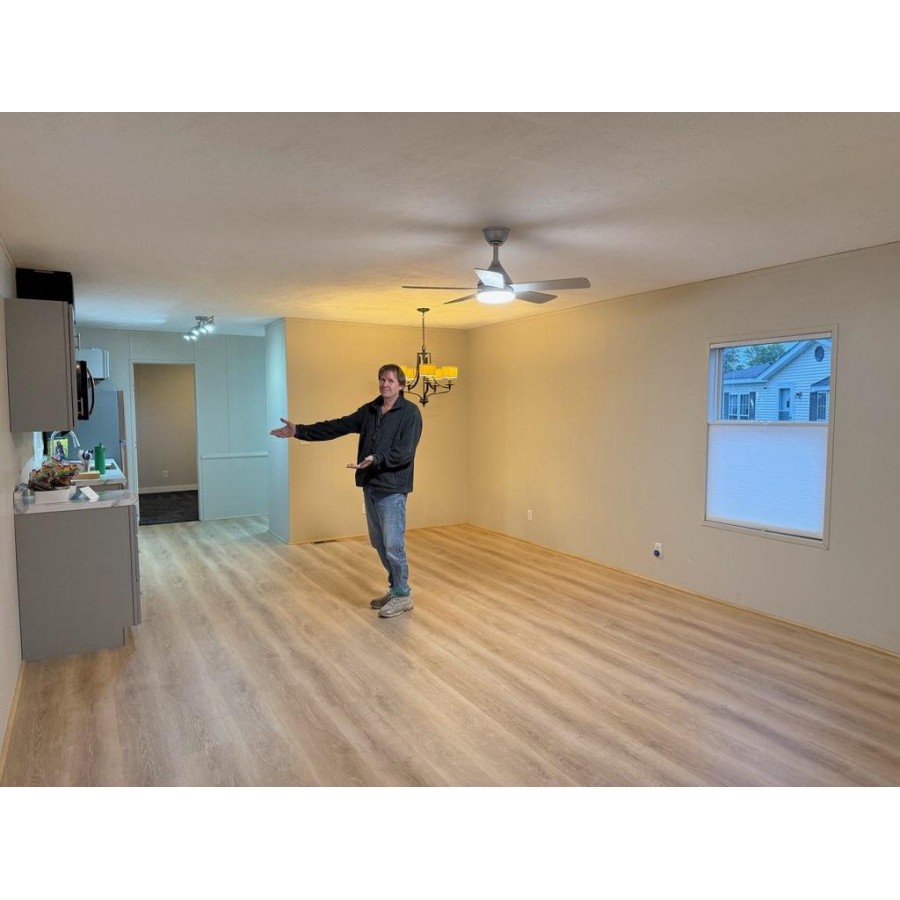

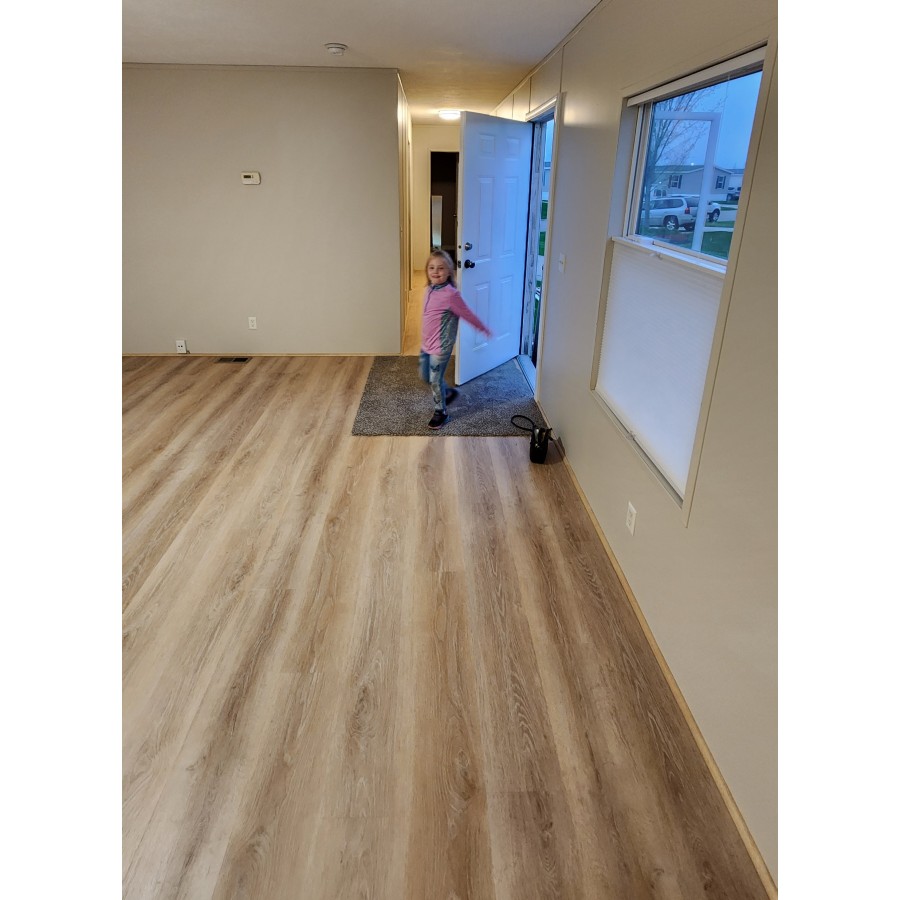

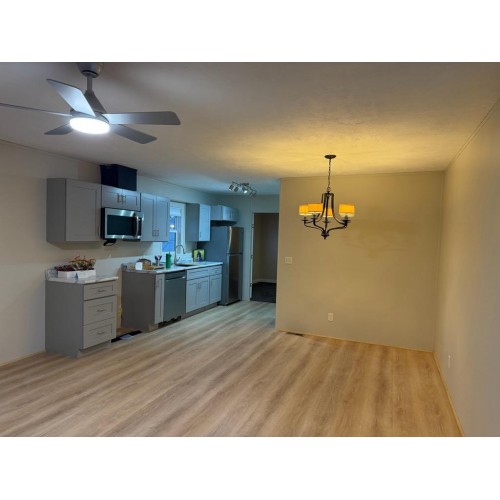

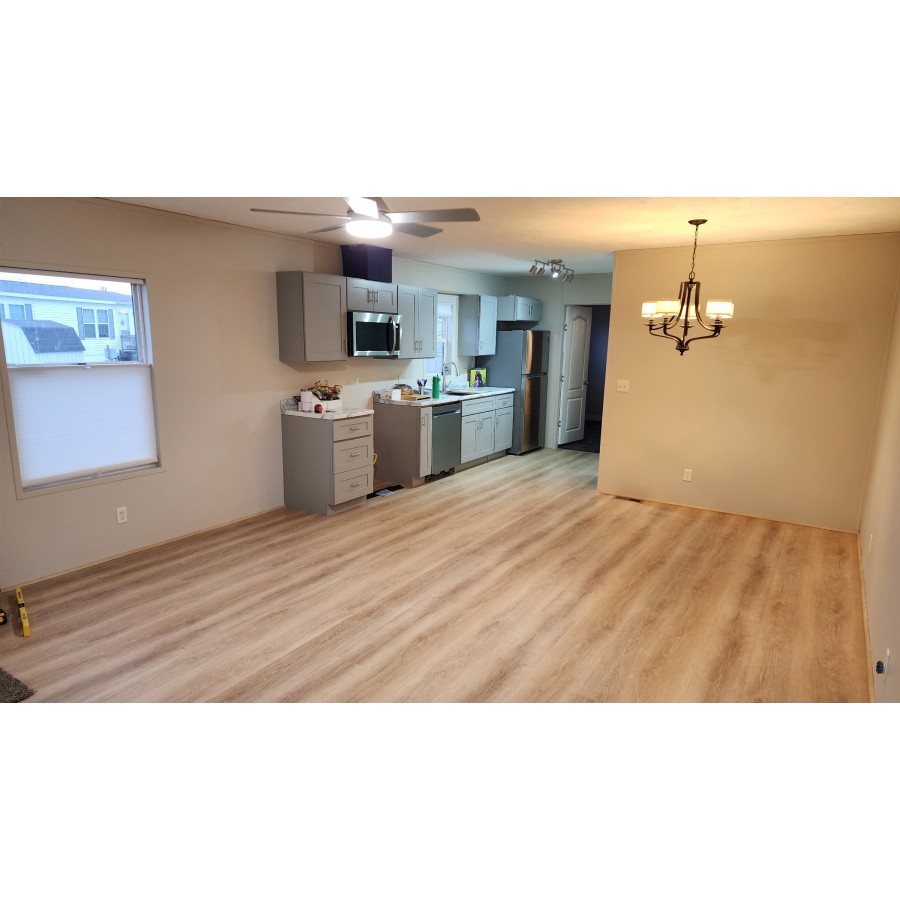

- move in day
Pending
====================================
FYI
- to secure the skirt around the bottom, i see a lot of "others" screwing then to the top and bottom.
====================================
- Product Code: 1125
- Availability: In Stock

-50x50.jpg)
-600x600.jpg)
-500x500.jpg)

-500x500.jpg)

-500x500.jpg)
-500x500.jpg)
-500x500.jpg)
-500x500.jpg)

-500x500.jpg)
-500x500.jpg)
-500x500.jpg)
-500x500.jpg)
-500x500.jpg)
-500x500.jpg)
-500x500.jpg)

-500x500.jpg)

-500x500.jpg)
-500x500.jpg)

-500x500.jpg)

-500x500.jpg)
-500x500.jpg)

-500x500.jpg)

-500x500.jpg)

-500x500.jpg)
-500x500.jpg)
-500x500.jpg)

-500x500.jpg)
-500x500.jpg)
-500x500.jpg)

-500x500.jpg)
-500x500.jpg)
-500x500.jpg)
-500x500.jpg)

-500x500.jpg)
-500x500.jpg)
-500x500.jpg)
-500x500.jpg)
